Skip to main content

Import a Project (CSV or JSON)

LoopGantt can create a project from a file: its own JSON export, a CSV spreadsheet (from Excel, Google Sheets or most PM tools), or the export files of Asana, Trello and Microsoft Project. The Import Project dialog recognizes which kind of file you dropped and converts it for you.

How to import

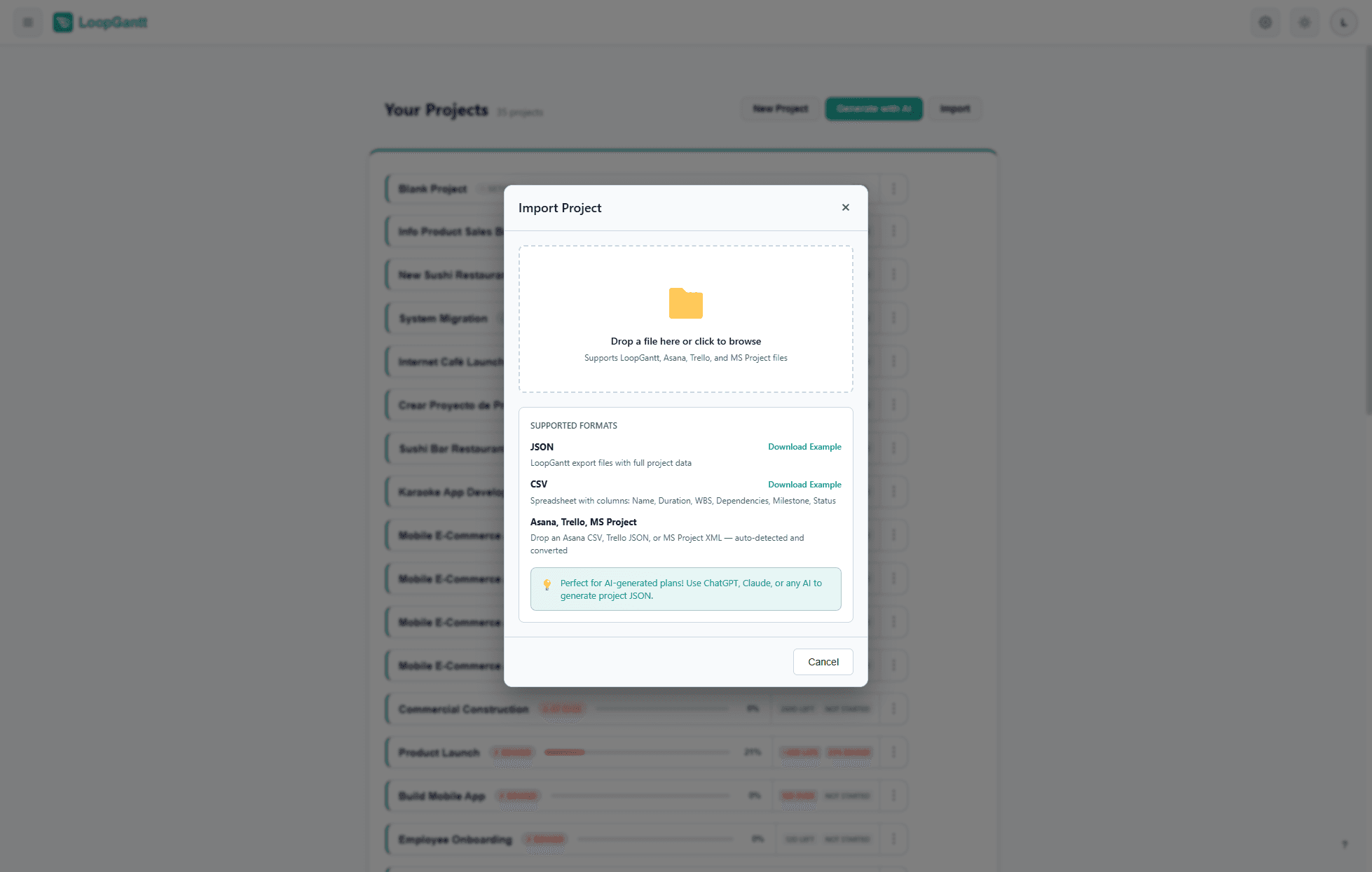

Import Project modal showing drag-and-drop zone and supported formats: JSON, CSV, Asana, Trello, MS Project
The Import modal reads LoopGantt JSON and CSV files, plus Asana, Trello and MS Project exports
  1. On your dashboard, click Import.
  2. Drop a .json, .csv or .xml file (up to 15 MB) into the Import Project dialog, or click to browse.
  3. Check the preview: the detected format (for Asana, Trello and MS Project files), the project name, the number of tasks and dependencies, and the first tasks of the plan. Notes under the preview list anything that was skipped or approximated.
  4. Click Import Project to create the project.

Supported files

FileRecognized byDetails
LoopGantt JSON (.json)Its version, project and tasks fieldsSee "JSON format" below
CSV (.csv)A Name or Task columnSee "CSV format" below
Asana CSV exportAsana's own column headersImport from Asana
Trello board export (.json)Its lists and cardsImport from Trello
Microsoft Project XML (.xml)A project with tasks, as saved by File → Save As → XMLImport from Microsoft Project

CSV format

Download the example CSV to see the format. LoopGantt matches columns by their header, in any order and in upper or lower case. Only the name column is required.

Column (other accepted headers)RequiredDescription
Name (Task, Task Name)YesTask or phase name
Duration (Days) (Duration, Days)NoWorking days. Use 0 for milestones and phases. Without a duration, a task is one day long.
Start, End (Start Date, End Date, Finish, Due, Deadline)NoA task starts on its Start date. When a row has no duration, the working days from Start to End, both included, become the duration. With only an End date, the task ends on that date.
WBS (ID, #)NoOutline number such as 1.2. A row with children (1 above 1.1) becomes a phase that contains them.
PhaseNoYes to make this row a phase
MilestoneNoYes to mark as a milestone (duration must be 0)
Dependencies (Predecessors, Depends On)NoPredecessors, separated by commas or semicolons. See below.
StatusNonot_started · in_progress · completed · on_hold (also todo, done, blocked)
PriorityNolow · medium · high · critical
Progress (%)No0–100
ColorNocyan · blue · green · orange · red · purple · teal · pink · gray · indigo · amber · lime · fuchsia · neon. Common names such as yellow, violet or rose get the nearest of these colors.
ChecklistNoSemicolon-separated items. Mark a completed item with [x], before or after its text. Example: [x] Design wireframes;Get approval;Write docs
Description (Notes)NoTask description. When a file has both columns, Description is used.

Dependency syntax

Name each predecessor by its exact name, its WBS number or its row number:

Design Review
1.4
Design Review, QA & Bug Fixing

A dependency is Finish-to-Start with no lag unless you add a type after the predecessor: FS, SS, FF or SF, optionally followed by a lag in days (+ to wait, - to overlap). Write the type in parentheses or straight after the predecessor:

Wireframes (SS+2)
QA & Bug Fixing (FF)
Beta / TestFlight (SS-3)
1.2FS+3

Upper or lower case and spaces don't matter, and a d or days after the lag is accepted, so a CSV exported from LoopGantt imports with its dependency types and lags.

JSON format

The JSON format is more expressive than CSV: it keeps phases and nesting, all four dependency types with their lag, status, priority, progress, colors, descriptions, checklists and start dates. An Export → JSON file from LoopGantt imports back as a new project.

Download the example JSON for a complete, annotated reference. Use it as a template when generating projects with ChatGPT, Claude, or Gemini — see Use Your Own AI to Generate a Project.

Importing from other tools

Coming from another tool? These guides cover the files LoopGantt reads directly:

For any other tool, export a CSV and match its headers to the table above, or ask an AI assistant to convert your export into LoopGantt JSON.

Note: Importing creates a new project, which counts toward your plan's project limit. It does not merge into an existing one. A plan can have up to 5,000 tasks.
